Corinth Secondary School - Progress update

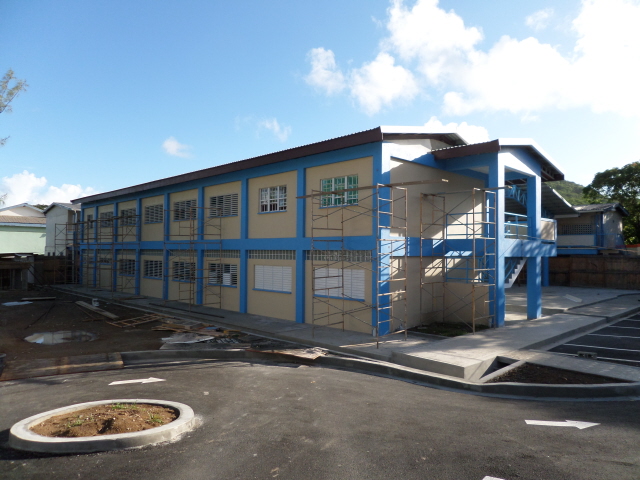

October 2015 - Phase 1 - is into finishes, right now we're basically painting the building, including floors and installing gutters and ceilings.



Phase 2 - is also into finishes, we're currently installing door frames, including ceiling frames and painting the internal walls.



Assembly Area - all columns and trussess completely painted.  We're currently waiting on the roof ridge ventilator to complete the roofing.



External works and Car park in phase 1 is  completed.
